Case Study
✓ Delivered on time
Agricultural Equipment

John Deere CP690 Cotton Picker Shipping to Greece: Flat Rack Export Case Study
Shipped United States → Greece

How Atlantic Project Cargo moved a John Deere CP690 cotton picker from Alabama to Thessaloniki — fully EU phytosanitary-compliant, on a route with no direct RoRo service, delivered on schedule with zero unexpected costs.

Shipment Route

Alabama
United States
Thessaloniki
Greece
Equipment John Deere CP690 Cotton Picker
Cargo Type Oversized Agricultural
Total Timeline 44 days
Method Flat Rack Container (40-foot)
Worldwide Shipping
Americas · Europe · Asia Pacific · Africa
100,000+
Shipments Worldwide
20+ Years
In Heavy Cargo Logistics
4.9 Rating
on Google · 50+ reviews
Licensed Freight Forwarding Company
Home Projects John Deere CP690 Cotton Picker Shipping to Greece: Flat Rack Export Case Study Shipped from United States to Greece

Shipping Overview

Equipment John Deere CP690 Cotton Picker
Origin Alabama, United States
Destination Thessaloniki, Greece
Shipping Method Flat Rack Container (40-foot)
Cargo Type Oversized Agricultural
Transport Mode Inland Lowboy Trailer + Ocean Flat Rack Freight
Compliance EU Phytosanitary Regulations · USDA Certification · Customs
Total Timeline 44 days

This case follows the export of a John Deere CP690 cotton picker from Alabama, USA to Thessaloniki, Greece — combining inland lowboy transport, mechanical disassembly, and strict EU phytosanitary compliance, executed via flat rack container since no direct RoRo route exists on this lane.

Weighing in at roughly 55,000–65,000 pounds even in its disassembled shipping configuration, and standing nearly 14 feet tall, the machine exceeded standard shipping dimensions and required custom routing. The objective: deliver on schedule, fully compliant with EU import regulations, with zero delays or additional handling costs at the destination port.

Key Takeaways

Why projects like this succeed — or get stuck at the port.

Direct RoRo service from the US to Greece is limited, and equipment this size and weight typically exceeds standard RoRo car-carrier deck specs — so oversized cargo like this has to move via flat rack instead.

The EU enforces zero-tolerance phytosanitary policy: any trace of foreign soil, plant debris, or pests fails inspection.

Port storage fees can exceed $150/day — controlled sequencing of prep, certification, and vessel schedules is what protects the timeline.

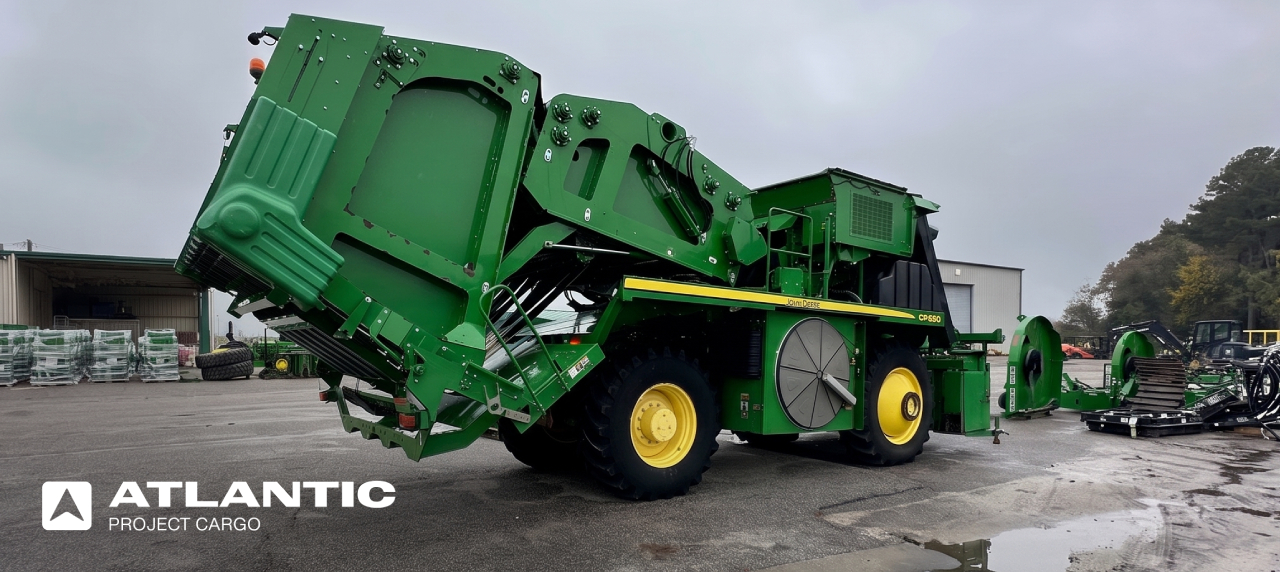

The John Deere CP690 exceeded the height and weight thresholds for standard containerized shipping, requiring header removal and basket folding to reduce height by nearly three feet for safe flat rack stowage and crane handling.

Choosing flat rack shipping over a chartered Breakbulk vessel saved the client approximately $6,500 in freight costs.

Greek ports (Thessaloniki, Piraeus) rely on feeder vessels and indirect routing, unlike major northern EU hubs like Bremerhaven, Antwerp, or Rotterdam.

Four Risks, Four Fixes

This case follows the export of a John Deere CP690 cotton picker from Alabama, USA to Thessaloniki, Greece — on a route with no direct shipping service and strict EU compliance requirements.

Improper disassembly

Incorrect header removal or basket folding can cause transport issues and even road accidents en route to the port.

Certified mechanical disassembly

Header removal and basket folding performed by certified heavy machinery mechanics, reducing height by nearly three feet within safety tolerances.

Incomplete phytosanitary cleaning

Any trace of soil, plant residue, or organic material fails EU inspection, triggering rejection or costly re-treatment at the destination.

High-pressure steam cleaning + certification

Full removal of soil and organic material via high-pressure steam, verified against EU import regulations, with official phytosanitary certification issued.

Missing documentation

A single missing digit on a serial number or absent certificate can stall a shipment for weeks at customs.

Full pre-export document package

Condition reports with high-resolution photography, serial number verification against bill of sale, and complete export/import documentation assembled in advance.

Poor coordination

Missed vessel cut-offs from uncoordinated prep, certification, and scheduling lead to massive port storage fees.

Controlled stage sequencing

Preparation teams, USDA certification, and vessel schedules synchronized end-to-end to avoid port storage delays.

How the timeline played out

From inland pickup to final delivery — the full 42-day journey.

Pre-departure phase

Inland pickup, disassembly, cleaning/certification, documentation, flat rack loading

14 days

Ocean freight

Flat rack transit to Thessaloniki

28 days

Customs clearance at Thessaloniki

Cleared customs, reassembled, operational.

Within 48 hours

Delivered

Door to door

44 days

How Each Phase Was Handled

Nothing improvised. Every step below was pre-planned and validated before execution began.

Inland Pickup and Transport

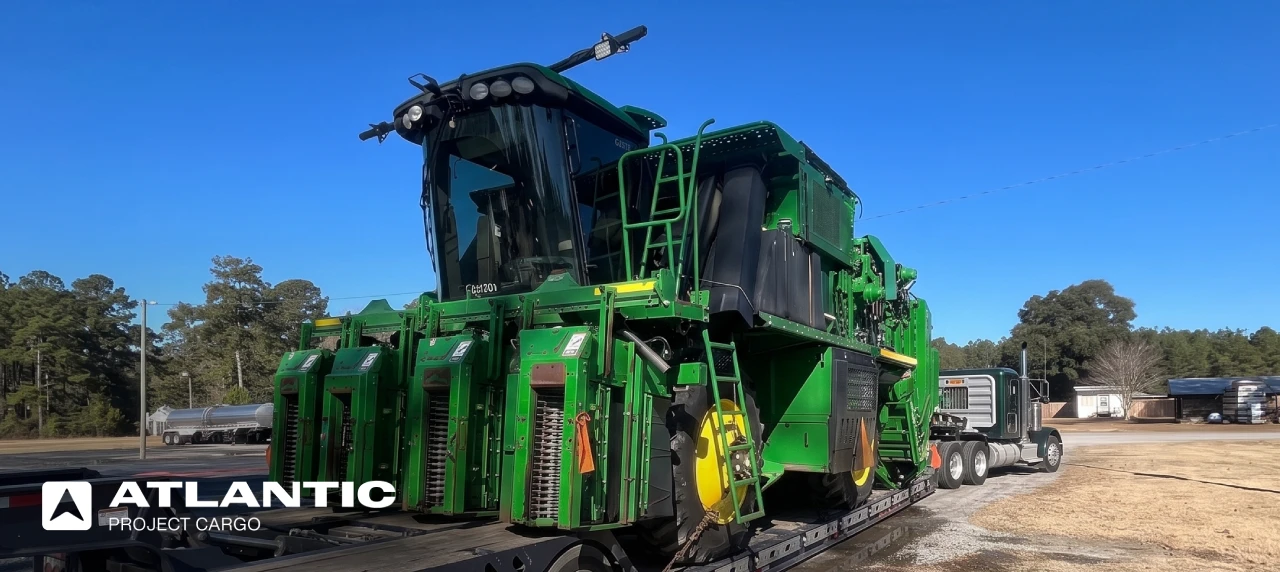

Equipment collection was scheduled in rural Alabama. Route planning avoided low bridges and weight-restricted roads, oversized transport permits were secured across multiple state lines, and the machine was delivered safely to a specialized packing facility near the departure port.

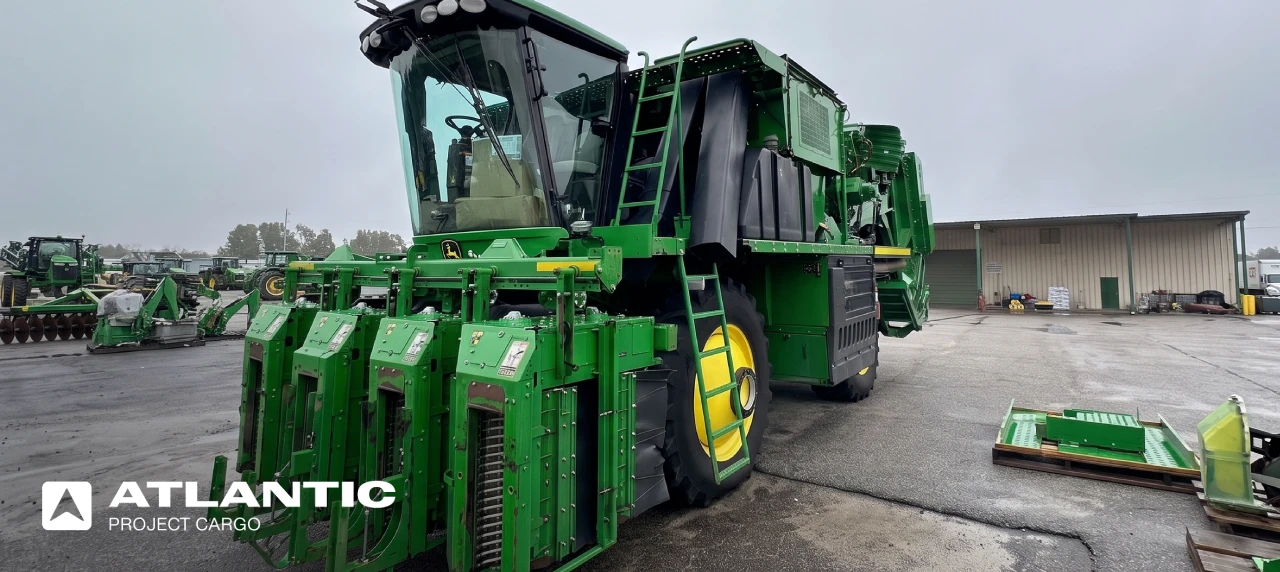

Equipment Preparation (Disassembly and Configuration)

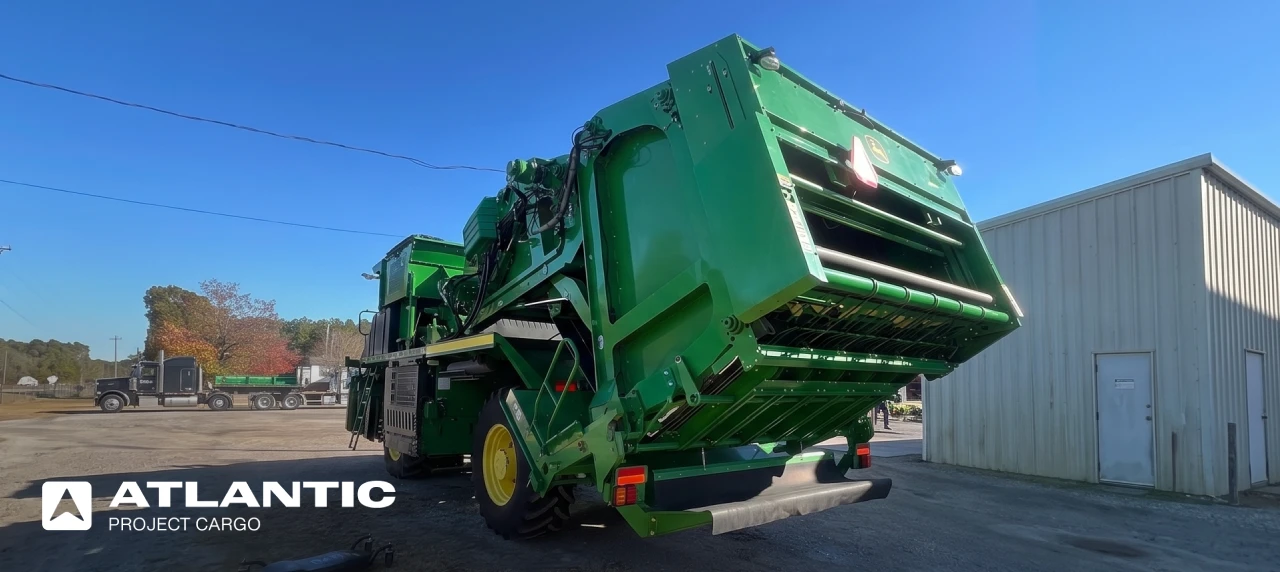

To fit the machine onto a flat rack and reduce ocean freight costs, its physical footprint had to be altered. Header removal was performed by certified heavy machinery mechanics, and basket folding reduced overall height by nearly three feet — dimension adjustments confirmed the machine fit within safety tolerances for crane handling and loading.

Phytosanitary Cleaning and Certification

Meeting EU phytosanitary requirements is the most critical step of the process — inspectors check for soil, plant debris, and quarantine pests, and can physically inspect the machine on arrival if anything looks noncompliant. Soil, plant residue, and hidden organic material were removed using high-pressure steam, compliance was verified against EU import regulations, and official federal certification was issued with zero organic material remaining.

Documentation and Pre-Export Preparation

Equipment condition reports were generated with high-resolution photography, serial numbers were verified against the bill of sale and export declarations, and a complete export documentation package was assembled for US Customs — with Greek import documentation prepared in advance as well.

Flat Rack Shipping to Thessaloniki

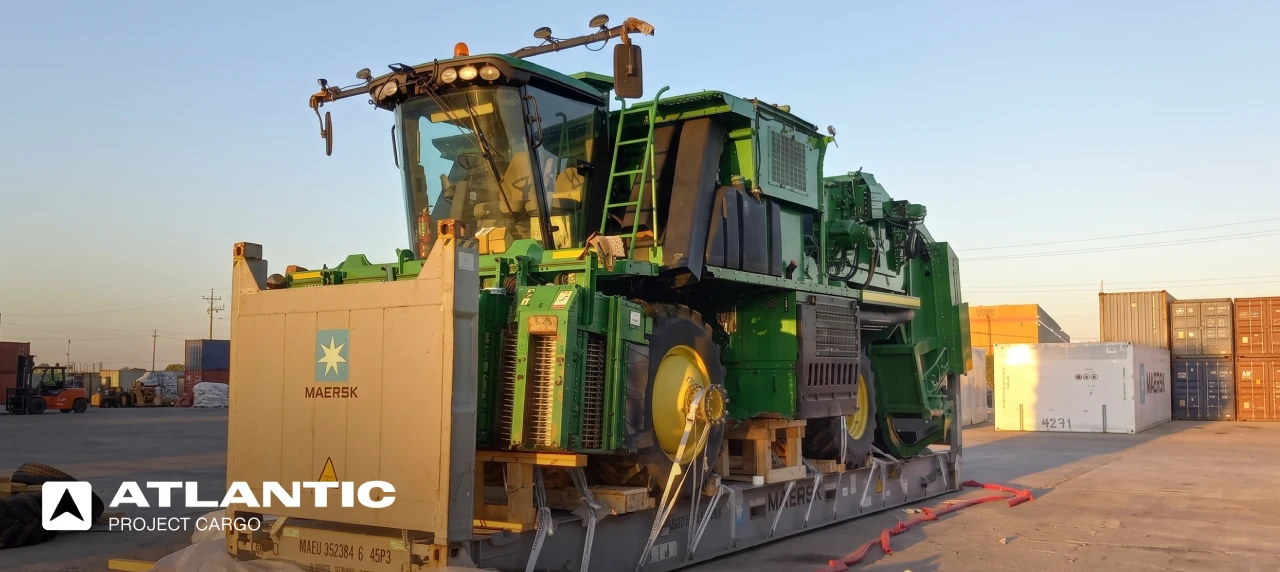

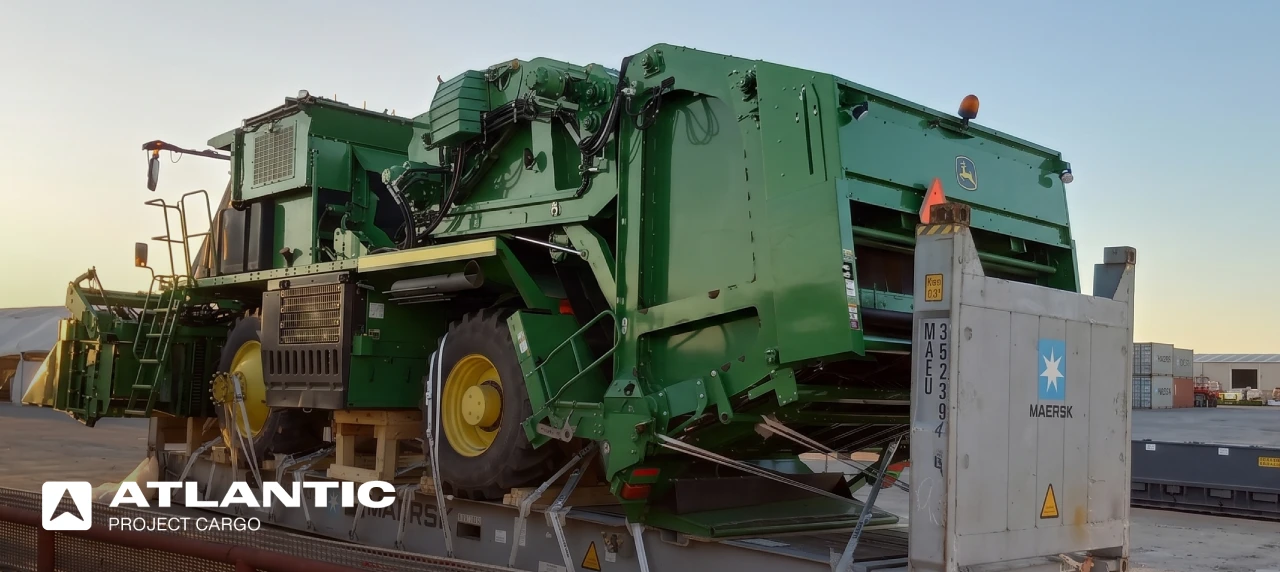

A flat rack is a shipping container with no sides or roof, letting oversized cargo extend beyond standard dimensions while still fitting a vessel’s cellular guides. A 40-foot flat rack was selected based on route availability and size constraints. Loading, blocking, bracing, and lashing used heavy-duty steel chains and specialized straps, with securing certified by independent marine surveyors and a pre-departure inspection confirming full maritime safety compliance.

We Can Help Ship Your Equipment to Greece!

Whether it’s a cotton picker or a combine harvester, Atlantic Project Cargo builds custom routes and manages end-to-end compliance for agricultural equipment shipping to Greece and across Europe.

  • Full compliance handling — EU phytosanitary regulations, USDA certification, customs brokerage.
  • Transparent timeline & fixed-scope pricing.
  • Custom route engineering when direct shipping options don’t exist.
  • 20+ years moving oversized cargo worldwide.

Full route timeline

Every phase of the shipment, what happened in it, and how long it took — door to door.

Phase What Happened Duration
Inland pickup & transport Collected in Alabama; route planned around low bridges and weight limits; permits secured. Within 14-day pre-departure window
Equipment preparation Header removed, basket folded; height reduced by nearly 3 feet. Within 14-day pre-departure window
Phytosanitary cleaning & certification High-pressure steam clean; EU compliance verified; certification issued. Within 14-day pre-departure window
Documentation Condition reports, serial verification, export/import documentation assembled. Within 14-day pre-departure window
Flat rack loading & departure 40-foot flat rack selected; blocked, braced, lashed; marine surveyor certified. Within 14-day pre-departure window
Ocean freight Flat rack transit to Thessaloniki. 28 days
Customs clearance Cleared at the Thessaloniki port of entry. Within 48 hours
Door to door  Pickup → Greek customs clearance → Handover 44 days

Delivered Without Delays or Additional Costs

The John Deere CP690 arrived safely in Greece right on schedule, with smooth customs clearance and no re-treatment or unexpected costs.

Delivered

Successful arrival and discharge in Thessaloniki, on schedule.

Cleared

Customs clearance processed within 48 hours, no re-treatment required by local agricultural inspectors.

As-quoted

No port delays or unexpected expenses billed to the client; flat rack method saved ~$6,500 vs a chartered Breakbulk vessel.

Operational

Equipment delivered to the farm ready for immediate use.
