Hours of operations:
9AM - 5PM / UTC -5 (EST)
Case Study
✓ Delivered on time
Agricultural Equipment

John Deere X9 1100 Combine Shipping – USA to New Zealand
Shipped USA → New Zealand

Export of a John Deere X9 1100 combine from North Dakota to New Zealand, including oversized inland transport, equipment preparation, biosecurity cleaning, flat rack loading, and ocean freight coordination.

Shipment Route

Fargo, North Dakota
USA
Lyttelton
New Zealand
Equipment John Deere X9 1100 Combine Harvester, 2022 model
Cargo Type Agricultural Equipment
Total Timeline 39 days, collection in Fargo to release in Canterbury
Method Flat Rack Ocean Freight
Worldwide Shipping
Americas · Europe · Asia Pacific · Africa
100,000+
Shipments Worldwide
20+ Years
In Heavy Cargo Logistics
4.9 Rating
on Google · 50+ reviews
Licensed Freight Forwarding Company
Home Projects John Deere X9 1100 Combine Shipping – USA to New Zealand Shipped from USA to New Zealand

This John Deere X9 1100 combine was sold to an arable and cropping operation in Canterbury, New Zealand, with the machine located in Fargo, North Dakota. A combine of this size doesn’t travel in its field-ready configuration: the header had to come off and the unloading auger folded before the machine could move by road or by sea. Because it was also used agricultural equipment, it needed preparation for New Zealand’s biosecurity requirements – and, with the shipment falling inside the September-to-April Brown Marmorated Stink Bug risk season, an approved offshore treatment – before it could be accepted for import.

This project combined two logistics challenges: transporting one of the largest types of agricultural machinery, and preparing used farm equipment for New Zealand’s biosecurity controls. Atlantic Project Cargo coordinated the inland transport, equipment preparation, and ocean freight needed to get the X9 1100 from Fargo to Lyttelton.

Shipping Overview

Equipment John Deere X9 1100 Combine Harvester, 2022 model
Origin Fargo, North Dakota, USA
Destination Lyttelton, New Zealand
Shipping Method Flat Rack Ocean Freight
Cargo Type Agricultural Equipment
Compliance Inland Heavy Haul, Oversized Route Planning, Equipment Disassembly / Preparation, Biosecurity Cleaning Coordination, BMSB Offshore Treatment Coordination, Flat Rack Loading, Blocking and Bracing, Cargo Securing, Export Documentation, Ocean Freight Coordination, Destination Coordination
Total Timeline 39 days, collection in Fargo to release in Canterbury

Key Takeaways

Oversized Combine Transport
A John Deere X9 1100 is too large to move by road or by sea in its field-ready configuration. At roughly 9.5 meters long and close to 4 meters wide across its rear tires, it dictated the inland route from Fargo to Los Angeles, the oversize permits needed through five states, and the RGN trailer used to haul it.

Header Removal
The 45-foot flex draper header was removed and the unloading auger folded to bring the combine within shippable dimensions. It’s standard practice for a machine this size, and it also opens up the feeder house, auger housing, and header mounting frame for the cleaning stage that follows.

Biosecurity Preparation
Because the X9 1100 is used agricultural equipment, it needed a level of cleaning beyond a standard wash before it could be presented for export to New Zealand. Used machinery that has worked in fields carries organic material that New Zealand’s biosecurity system is specifically built to catch.

Hard-to-Reach Cleaning Areas
Combines are built with numerous cavities, harvesting components, guards, and undercarriage areas where soil, seed, and crop residue can collect and stay hidden from a surface inspection. Reaching those areas – without needing to dismantle the threshing rotors themselves – is what separates an adequate wash from one that holds up to inspection.

Flat Rack Shipping
The X9 1100 moved by flat rack rather than a standard container or RoRo service – the loading method suited to a machine of its dimensions once reduced to shippable size. The header shipped separately, on its own flat rack, loaded on its side.

New Zealand Arrival Inspection
On arrival, the machine was presented to Biosecurity New Zealand for the standard quarantine inspection required of imported machinery before release.

Four Risks, Four Fixes

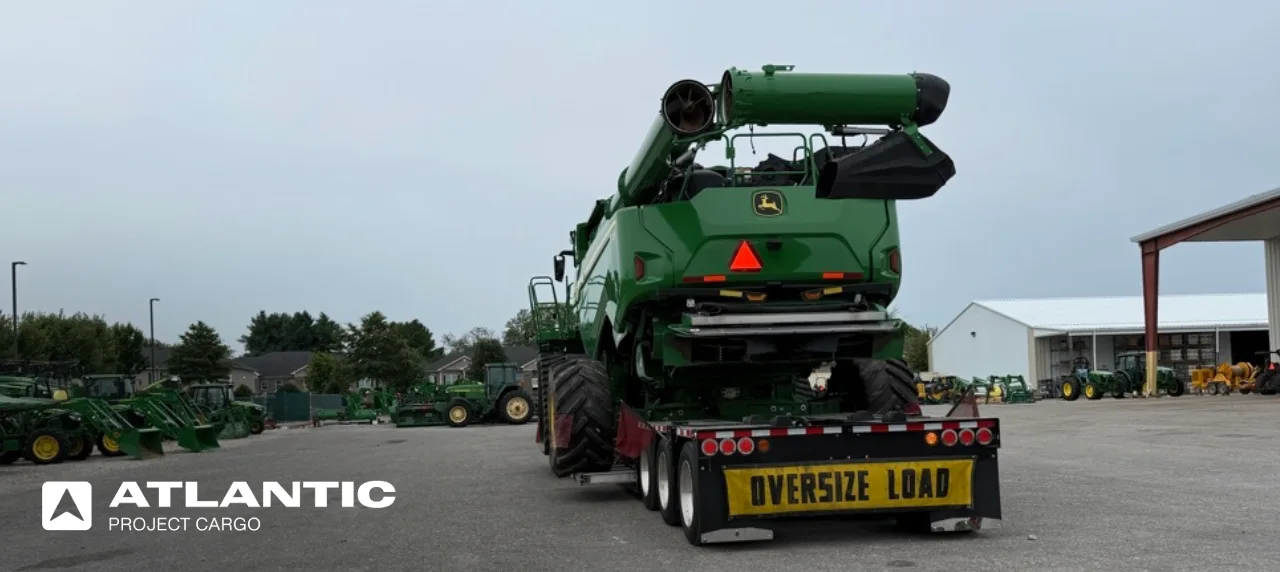

Oversized Transport Dimensions

The John Deere X9 1100 could not be transported internationally, or even moved inland, in its normal operating configuration. Its dimensions and weight as a field-ready machine exceed what standard road transport and ocean freight can accommodate.

Component Removal and Shipping Preparation

The 45-foot flex draper header was removed, the unloading auger folded to its transport position, and the combine’s folding grain tank extensions lowered – bringing the unit within shippable dimensions ahead of inland transport and loading. Atlantic Project Cargo coordinated this preparation with a heavy-equipment prep facility near the Fargo yard.

Biosecurity Contamination

Used combines can retain soil, seeds, crop residue, plant material, and insects in places a casual inspection won’t find. This risk is higher on a combine than on many other equipment types because of how many enclosed and hard-to-reach areas a harvesting machine has by design.

Detailed Pre-Export Cleaning

The X9 1100 was cleaned at a licensed agricultural wash facility near the Port of Los Angeles, with high-pressure hot-water washing, compressed air, and vacuuming applied to the feeder house, threshing area (through its access panels, without dismantling the rotors), unloading auger, header mounting frame, and undercarriage. New Zealand’s biosecurity system requires imported machinery to arrive clean and free of biosecurity risk material under the Vehicles, Machinery and Parts Import Health Standard – that standard, not a general cleanliness target, is what the preparation was measured against.

Additional Cleaning or Treatment After Arrival

If contamination is identified during the destination inspection, machinery can be held for further inspection, cleaning, or treatment, or referred to an approved Transitional Facility before release – a costly and time-consuming outcome on a shipment already on a timeline.

Pre-Export Verification

Once cleaning was complete, the combine’s cleanliness and the shipping and biosecurity documentation were checked by Atlantic Project Cargo’s team before it left the wash facility, and the shipment’s offshore BMSB treatment was scheduled to fall within the required window ahead of departure. Pre-export cleaning and checks reduce the likelihood of an issue at the New Zealand border; they are not a guarantee of first-pass clearance, which rests with Biosecurity New Zealand’s own inspection.

Cargo Movement During Ocean Transport

The combine’s weight, dimensions, high center of gravity, and separately shipped header create securing requirements beyond what a standard container shipment needs, both during terminal handling and the ocean crossing itself.

Flat Rack Loading and Cargo Securing

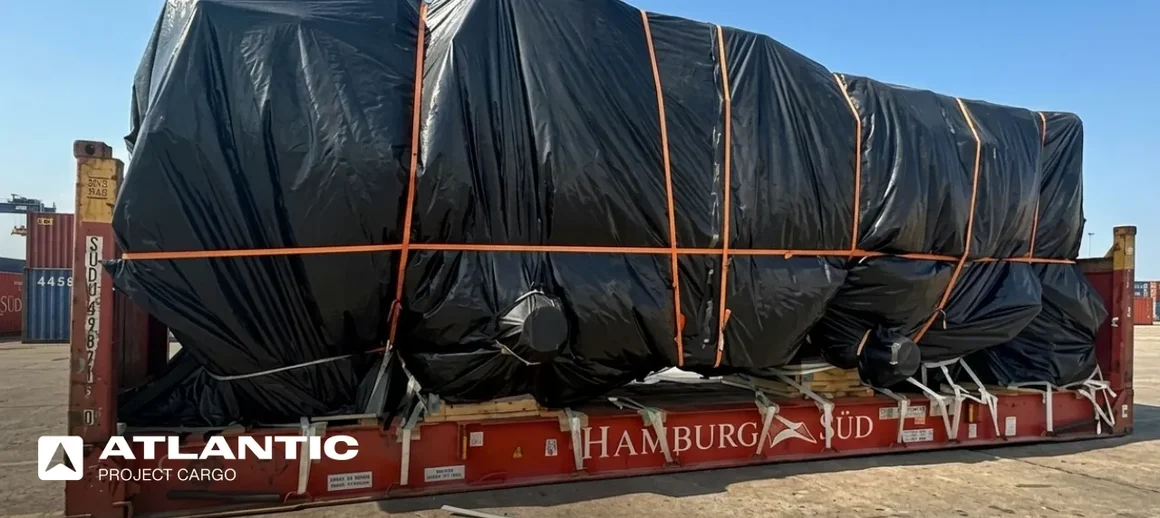

The X9 1100 was positioned on a 40-foot flat rack with its weight centered over the rack’s rated lift points, then blocked, chocked, and lashed down with rated chain and turnbuckle restraints. The header was loaded on its side on a second flat rack and secured the same way. Both racks passed a National Cargo Bureau stowage inspection before being released for loading.

How the timeline played out

From booking to delivery — the full 30–35 day journey, phase by phase.

Booking Confirmed

John Deere X9 1100 shipment scoped and confirmed with the Canterbury buyer.

Day 1

Pickup Planning

Dimensions, weight, inland route, and oversized transport requirements reviewed.

2 days

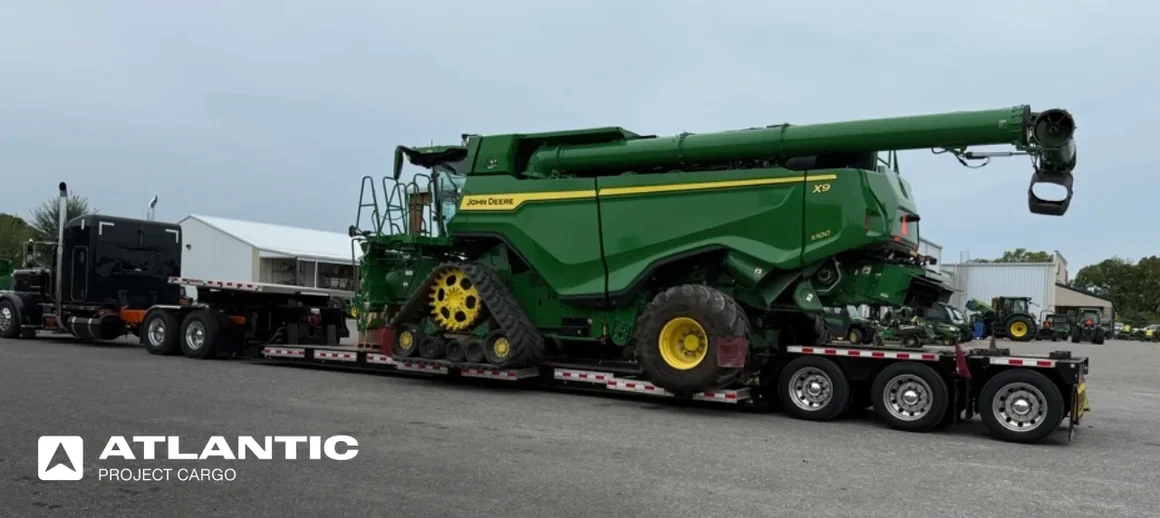

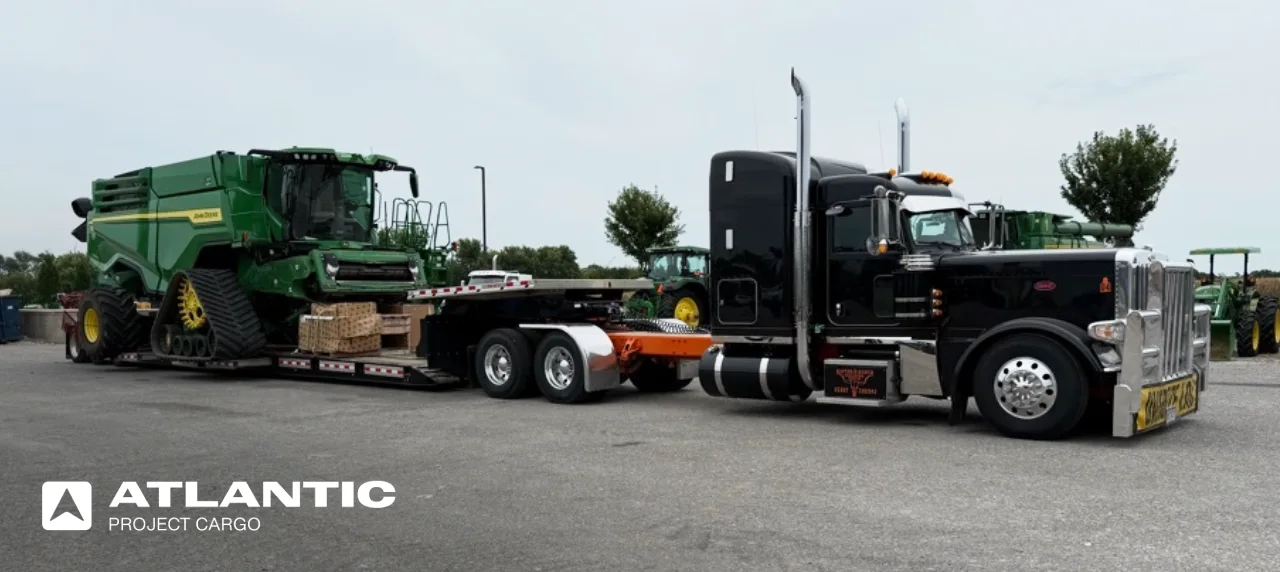

Inland Transport

Combine collected from Fargo and hauled to the Port of Los Angeles.

5 days

Equipment Preparation

Header removed and unloading auger folded.

1 day

Biosecurity Cleaning

Combine cleaned and prepared for New Zealand biosecurity requirements, BMSB offshore treatment scheduled.

2 days

Flat Rack Loading

Combine and header prepared and secured for ocean transport.

1 day

Ocean Freight

Equipment exported from Los Angeles to Lyttelton, via Auckland.

22 days

Arrival Inspection & Release

quipment presented for Biosecurity New Zealand’s quarantine inspection and released.

3 days

How Each Phase Was Handled

Pickup, Disassembly, and Shipping Preparation

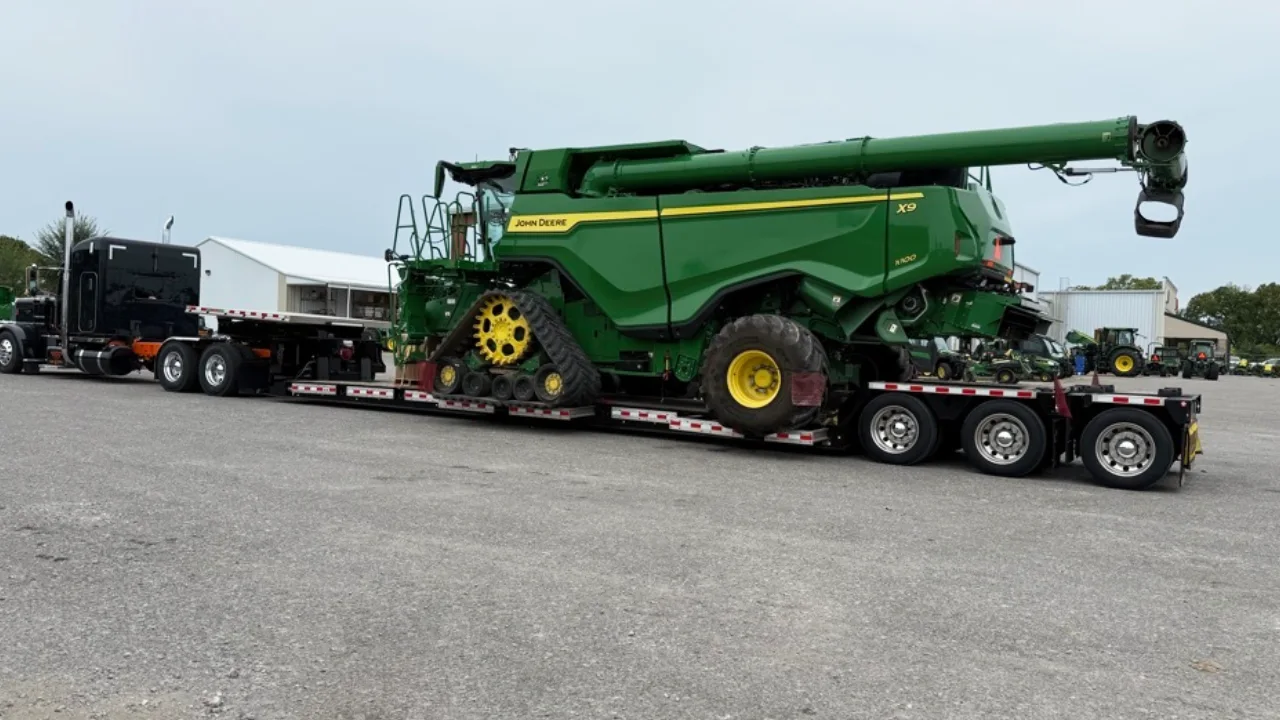

The X9 1100 was collected from the selling operation’s yard outside Fargo, North Dakota, where its dimensions and weight as a field-ready combine set the terms for everything that followed: a route to the Port of Los Angeles routed through North Dakota, South Dakota, Wyoming, Utah, Nevada, and California, with oversize permits secured for each state and the combine hauled on an RGN trailer. Before the combine could be transported to the wash facility, the 45-foot flex draper header was removed and the unloading auger folded to its transport position. Atlantic Project Cargo coordinated the mechanical preparation through a contracted equipment facility rather than performing the disassembly directly.

Oversized Route Planning – Five-state permitted route mapped from Fargo to the Port of Los Angeles.
Header Removal – 45-foot flex draper header removed ahead of transport.
Shipping Dimension Reduction – Combine brought within transportable and loadable dimensions before it left for the port.

Biosecurity Cleaning and Pre-Export Preparation

A used combine presents a higher contamination risk than most other equipment types, simply because of how it’s built: the threshing area, feeder house, header mounting frame, and undercarriage all create places where soil, seed, and crop residue can sit out of sight. The X9 1100 was cleaned at a licensed wash facility near the port, with high-pressure hot-water washing, compressed air, and vacuuming applied to those areas through their service panels, without dismantling internal components. Because the shipment fell inside New Zealand’s September-to-April BMSB risk season, an MPI-approved offshore treatment was also arranged, with the treatment certificate folded into the documentation package required under the Vehicles, Machinery and Parts Import Health Standard.

Detailed Equipment Cleaning – High-pressure wash, compressed air, and vacuuming of the threshing area, feeder house, header mounting frame, and undercarriage.
Hard-to-Reach Areas – Cavities, guards, and undercarriage areas addressed through service access panels.
Pre-Export Verification – Cleanliness, BMSB offshore treatment scheduling, and documentation checked ahead of departure.

Flat Rack Loading, Ocean Freight, and New Zealand Arrival

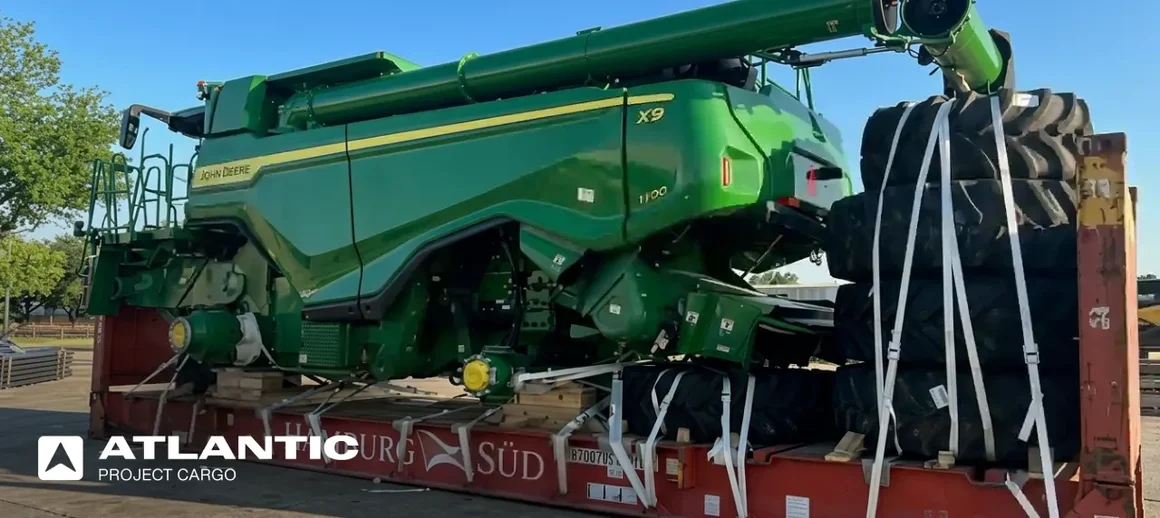

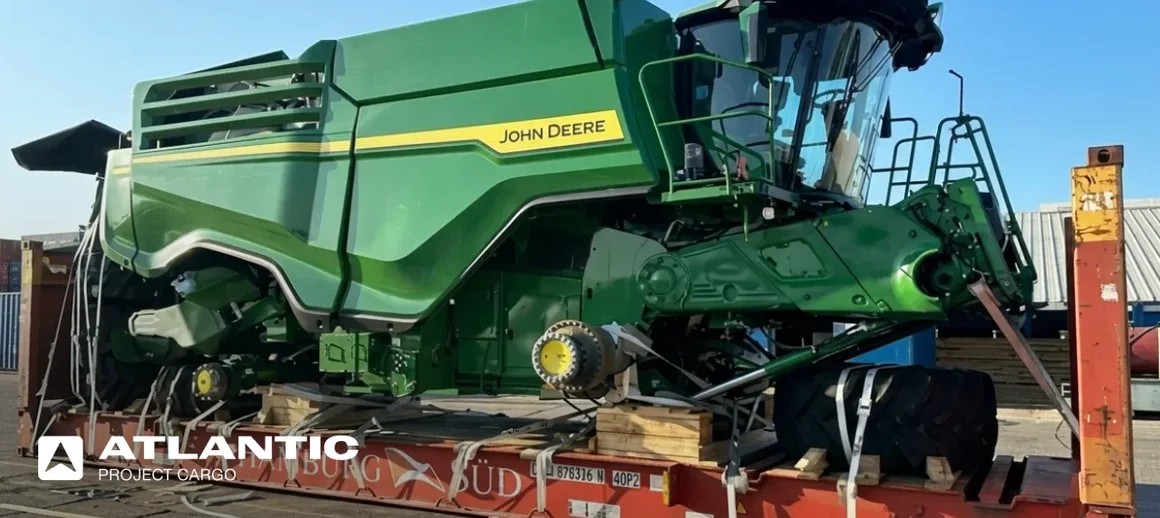

Once prepared, the combine was delivered to the Port of Los Angeles and loaded onto a 40-foot flat rack, with the header – loaded on its side on a second flat rack – blocked, braced, and lashed for the crossing. Both racks passed a National Cargo Bureau stowage inspection ahead of the vessel’s cutoff. Atlantic Project Cargo compiled the export documentation package – commercial invoice, packing list, bill of lading, AES/EEI export filing, and the New Zealand biosecurity records – and the shipment moved by ocean freight, calling at Auckland before continuing coastal to Lyttelton, a transit of roughly 22 days. On arrival, the equipment was presented to Biosecurity New Zealand for inspection before release to the buyer’s Canterbury operation.

Flat Rack Loading – Combine and header positioned, secured, and NCB-inspected ahead of sailing.
Export & Ocean Freight – Export documentation completed and the shipment moved from Los Angeles to Lyttelton via Auckland.
Arrival Inspection – Equipment presented for Biosecurity New Zealand’s quarantine inspection on arrival.

Shipping Farm Equipment to New Zealand?

Atlantic Project Cargo coordinates international shipping for combines, tractors, harvesters, and other agricultural equipment, including US pickup, equipment preparation, flat rack loading, export documentation, ocean freight, and destination coordination.

Full route timeline

Phase What Happened Duration
Booking confirmed John Deere X9 1100 shipment scoped and confirmed with the Canterbury buyer. 1 day
Pickup planning Equipment dimensions, weight, permits, route, and transport requirements reviewed. 2 days
Inland transport Combine transported from Fargo to the Port of Los Angeles on an RGN trailer. 5 days
Equipment preparation Header removed and unloading auger folded. 1 day
Biosecurity cleaning Combine cleaned and prepared for New Zealand biosecurity requirements. 2 days
Pre-export verification Equipment cleanliness, BMSB treatment scheduling, and documentation checked before export. 1 day, run in parallel with cleaning
Flat rack loading Combine and header positioned on their flat rack configuration. 1 day
Cargo securing Combine and header blocked, braced, and restrained; NCB stowage inspection completed. Same day as loading
US export Export documentation completed and cargo released for sailing. 2 days, run in parallel with preparation
Ocean freight Equipment shipped from Los Angeles to Lyttelton via Auckland. 22 days
Arrival inspection Equipment presented for Biosecurity New Zealand’s quarantine inspection. 1 day
Destination release Equipment released for onward transport after required procedures. 2 days
Door to door Fargo pickup through release in Canterbury, New Zealand. 39 days

Result

The John Deere X9 1100 was prepared for export, cleaned and treated to meet New Zealand’s biosecurity requirements, secured on flat racks for ocean transport, and shipped to Lyttelton. On arrival, the combine passed Biosecurity New Zealand’s quarantine inspection without referral to a Transitional Facility or need for additional treatment, and was released to the buyer’s Canterbury operation 39 days after collection in Fargo.

First-Pass MPI Clearance

The combine passed its arrival biosecurity inspection without referral for additional cleaning or treatment

0 Additional Treatments

No further treatment required at the New Zealand border beyond the offshore BMSB treatment completed before departure

2 Flat Racks

Combine and header shipped and secured separately for the ocean crossing

39-Day Door-to-Door Timeline

Fargo pickup through release in Canterbury
